Cerro Blanco Gold Project — 2022 Technical Report
| Company | Cerro Blanco Gold Project |
| Date | 2022 |
| Region | Not Specified |
| Commodities | Gold, Silver |
| Mine Type | Open Pit |
| Throughput | 4.0 Mt/a |
| Status | Development |
Executive Summary

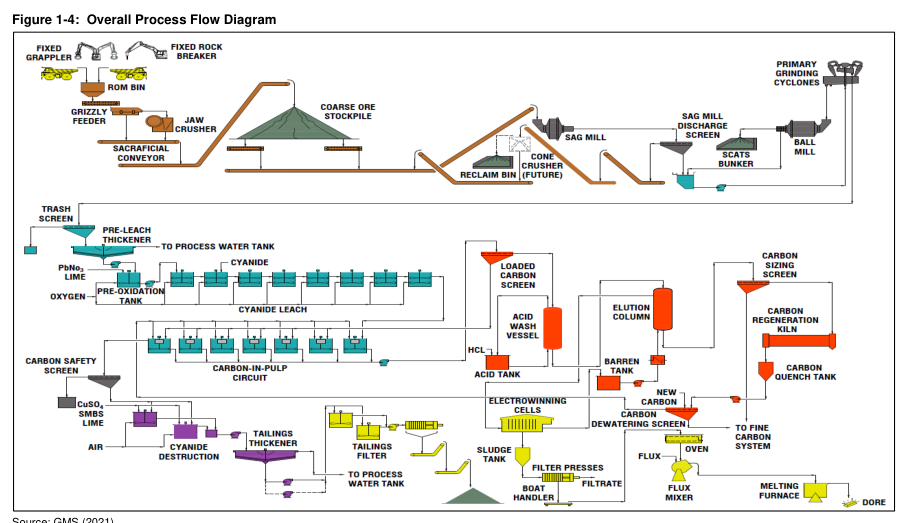

The Cerro Blanco Gold Project Technical Report outlines the process plant design for treating gold- and silver-bearing ore to produce doré. The flowsheet is based on metallurgical testwork and conventional unit operations, targeting a nominal throughput of 4.0 million tonnes per year. The design includes comminution, cyanide leaching, carbon adsorption via carbon-in-pulp (CIP), elution, and gold recovery circuits, with tailings treated in a cyanide destruction circuit.
Key operational criteria include a crushing plant availability of 75% and grinding/leach availability of 92%. The process utilizes a C160 Jaw Crusher, a SAG and ball mill grinding circuit, and a 36-hour leach residence time. The plant is designed to achieve 93% overall gold recovery and 84.3% silver recovery, with tailings filtered to a moisture content of 16-18% for dry stack storage.
Website: https://gmining.com/projects/cerro-blanco/
Report Date: 2022
Region: Not Specified
Project Status: Development
Commodity: Gold, Silver
Throughput: 4.0 Mt/a
Mine Life:
Mine Type: Open Pit
Ore type:
